How Do You Configure a 30 m³/Day NAAC Block Line?

Oct.26, 2026

A 30 m³/day non-autoclaved aerated concrete (NAAC) block production line should be configured around accurate material batching, controlled foam generation, efficient mixing, suitable molds, reliable cutting, and sufficient curing space. Unlike conventional autoclaved aerated concrete (AAC) plants, NAAC production does not require high-pressure steam autoclaves, which can reduce investment in autoclave-related equipment and infrastructure. Hengde provides NAAC block production line solutions that can be configured according to daily output, raw materials, block dimensions, factory space, and automation requirements.

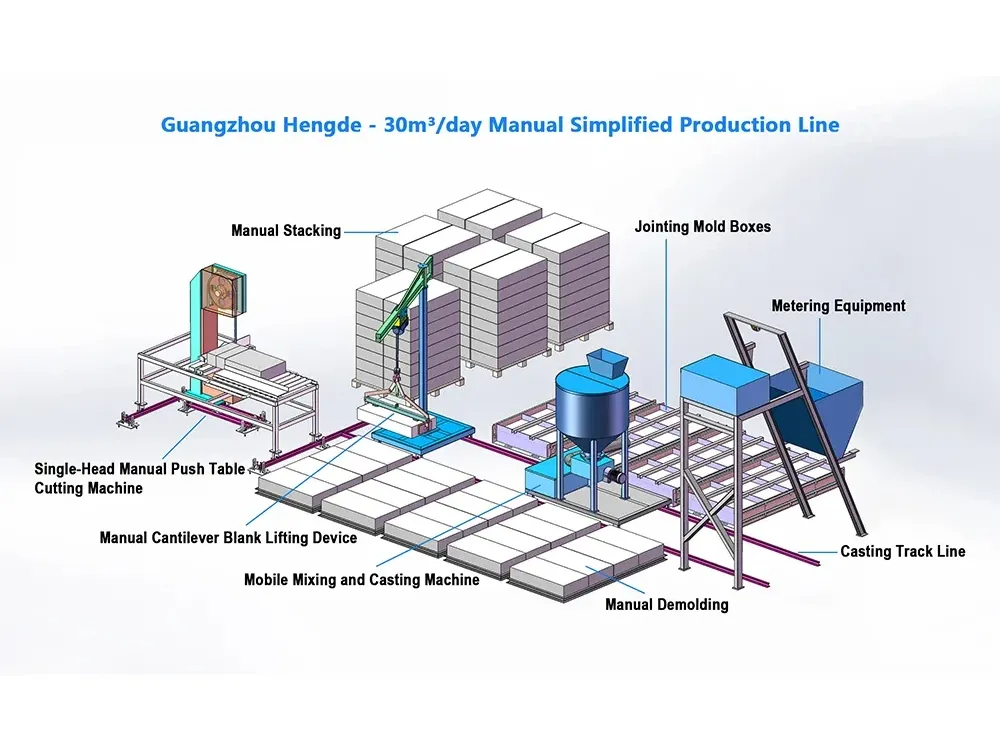

 30 Cubic Meter Block Production Line

What Equipment Does a 30 m³/Day NAAC Production Line Need?

For a small block factory, the objective is to coordinate each production stage without purchasing unnecessary automation. A compact line may use a combination of mechanical batching, a dedicated mixer, a physical foam generator, reusable molds, a cutting system, and manual or mechanical block handling.

The exact equipment list depends on the production process, raw materials, target density, and finished block specifications.



Production stageMain equipmentKey configuration consideration
Raw material storageSilos, hoppers, or bag-feeding equipmentMatch storage capacity to daily consumption and delivery frequency
Material batchingCement or fly ash metering, aggregate batching, and water measurementMaintain consistent mix proportions
Foam preparationPhysical foam generator, air compressor, and dosing linesProduce stable foam with a suitable density and bubble structure
Mixing and pouringLightweight concrete mixer and pouring arrangementDistribute foam evenly without excessive bubble damage
Molding and pre-curingReusable molds and a designated pre-curing areaProvide enough molds for setting and handling cycles
Demolding and cuttingMold-release equipment, hoist or clamp, and wire cutterMatch cutting capability to green-body strength and required block dimensions
Curing and storageCovered curing area, handling equipment, and palletsAllow sufficient space and time for strength development



Hengde's lightweight block and wall panel equipment can be evaluated by production stage when deciding whether a complete line or selected machines are more appropriate for the project.


1. How Should Raw Material Batching and Mixing Be Configured?


Material consistency is fundamental to NAAC block quality. Variations in cement, sand or fly ash, water, admixtures, and foam can affect slurry density, pore distribution, dimensional stability, and compressive strength.


Raw Material Storage and Feeding

A small plant can consider one or more compact storage silos, bag-feeding equipment, or a combination of the two. The choice depends on whether raw materials arrive in bulk, in bags, or through local suppliers.

Before selecting storage equipment, estimate daily material consumption using the proposed mix design. Allow for delivery intervals, material moisture, handling losses, and available site space.


Batching Accuracy

The batching system should measure each material within the tolerance required by the production process. Cementitious materials, aggregates, water, and admixtures may require different measurement arrangements.

Do not specify a universal ±1 kg batching accuracy without confirming the scale capacity, resolution, calibration, and operating conditions. The supplier should provide the actual equipment specifications and explain how they relate to the intended batch size.


Mixer Selection

A dedicated lightweight concrete mixer should distribute the base slurry and foam uniformly. Mixing time and speed need to be established through production trials because excessive mixing can damage foam bubbles, while insufficient mixing can create uneven density.

The mixer should also provide adequate working volume for the intended output and batch cycle. A machine that appears suitable by motor power alone may still be undersized if its effective batch volume or discharge time does not support the required production schedule.


2. What Foam Generation System Is Suitable for NAAC Blocks?


Physical foam generation is commonly used in foam-based NAAC production. A foam generator combines a suitable foaming agent solution with compressed air to create foam that is introduced into the base slurry.

Three factors are particularly important:



Foam stability: The foam should remain sufficiently stable during mixing, pouring, and early setting.

Foam density: Variations can affect the final block density and pore structure.

Dosing consistency: Repeatable foam addition helps maintain consistent batch performance.



The foaming agent dilution ratio must follow the chemical supplier's instructions. A ratio such as 1:40 may be appropriate for a particular product, but it should not be treated as a universal setting.

The air compressor, foam generator, metering arrangement, and mixer should be selected as a coordinated system. During commissioning, record the foam preparation parameters and verify the fresh slurry density before proceeding to full production.


3. How Many Molds Are Needed for 30 m³/Day?


Mold quantity depends on mold volume, filling time, pre-curing duration, demolding procedure, and the number of production hours available each day.

A simple planning calculation is:

Daily output = usable mold volume × completed mold cycles per day

For example, if each mold holds 0.864 m³ of usable slurry, producing 30 m³ would require approximately 35 completed mold cycles per day. This is an illustrative calculation, not a recommended mold specification; actual usable volume and production yield must be confirmed.

A commonly referenced mold envelope is approximately 1.2 m × 1.2 m × 0.6 m, but external dimensions do not necessarily equal usable filling volume. Confirm the internal dimensions, freeboard, and required green-body size with the equipment supplier.


How to Estimate the Mold Pool?


Estimate how long each mold remains occupied, from pouring through pre-curing and release. Then account for mold return, cleaning, preparation, and the time needed to move the green body to the next process.

The required mold pool is approximately:

Molds required = mold cycles per day × mold occupancy time ÷ daily production hours

Round the result upward and add an appropriate allowance for cleaning, handling delays, and unexpected interruptions. A supplier should verify the final quantity against the actual production schedule rather than relying on a fixed number of mold sets.


4. How Should Pre-Curing, Demolding, and Cutting Be Arranged?

NAAC production depends on the green body reaching sufficient strength for safe demolding and cutting. If cutting begins too early, blocks may deform, crack, or lose their edges. If the process is delayed unnecessarily, mold turnover slows and daily capacity can fall.


Pre-Curing Area

Provide a designated area where freshly poured material can set under controlled conditions. The required pre-curing time depends on the cementitious system, water-to-binder ratio, foaming system, ambient temperature, and other mix-design variables.

Avoid assuming that every formula can be demolded after the same number of hours. Production trials should establish a repeatable release window for the chosen materials and local climate.


Demolding Equipment

Depending on the line design, demolding may use a mechanical clamp, hoist, or gantry arrangement. The equipment should support the mold safely and avoid damaging the green body.

The handling method also affects the required aisle width, lifting height, operator access, and mold-return route.


Cutting System

A wire-cutting machine can be selected according to the block geometry, target dimensions, green-body strength, and required production rate. Rotary-table and vertical-cutting configurations may suit different layouts and handling sequences.

Do not treat ±1 mm cutting tolerance as a guaranteed result for every NAAC mixture. Achievable dimensions depend on the machine, wire condition, cutting method, green-body stability, and measurement procedure. Ask the supplier to state the guaranteed tolerance and the conditions under which it applies.


5. What Factory Space and Utilities Are Required?

The site must accommodate more than the main machines. Raw material storage, mixing, pouring, pre-curing, cutting, curing, finished-product storage, and vehicle access all compete for space.

Hengde's production line overview lists small-capacity block production configurations and indicates that space requirements can vary with output and layout. Treat a preliminary area estimate as a planning reference, not a final factory design.


Site requirementWhat to plan forWhy it matters
Production areaBatching, mixing, pouring, demolding, and cuttingKeeps material movement organized
Pre-curing spaceEnough positions for molds waiting to reach handling strengthPrevents the pouring stage from being blocked
Curing and storageSpace for blocks during strength development and finished-product storageAvoids premature dispatch and congestion
Raw material storageDry, accessible storage with suitable protectionHelps maintain material quality and reliable feeding
Electrical supplyVerified connected load, starting currents, and auxiliary equipmentPrevents undersized electrical infrastructure
Water supply and drainageWater for production, cleaning, and any required curing processSupports consistent mixing and orderly housekeeping
Handling routesForklift or trolley aisles and safe lifting accessReduces handling time and product damage



A 30 m³/day line may fit into a compact site, but the actual area depends on how long blocks remain in curing, how much inventory must be stored, and whether the facility operates one or multiple shifts. Finished-product inventory can require more space than the machinery itself.

Similarly, do not finalize an electrical capacity such as 25–30 kW until the selected equipment list is available. The mixer, air compressor, cutting system, conveyors, pumps, and auxiliary devices all contribute to the actual load.


6. How Can You Verify That the Line Really Produces 30 m³/Day?


A quoted capacity should be checked against the proposed production cycle and confirmed through commissioning. The important question is whether the complete line can consistently deliver the required volume of acceptable blocks, not merely whether an individual machine can process one batch quickly.


Calculate the Required Production Rate

For a plant targeting 30 m³ over an eight-hour production shift, the average finished output must be 3.75 m³ per hour. This is a planning calculation and does not account for downtime, rejected blocks, or differences between poured and finished volume.

The supplier should explain whether the quoted daily capacity refers to poured slurry, green-body volume, or saleable finished blocks.


Check the Full Production Cycle

During commissioning, record:



Number of batches mixed and poured per shift.

Actual volume per batch.

Time spent on mixing, pouring, mold release, cutting, and handling.

Mold occupancy and turnover time.

Reject rate and dimensional consistency.

Finished output after the specified curing period.

If the line reaches 30 m³ of poured material but a significant proportion of blocks are rejected, its saleable output will be lower than the nominal capacity.


Verify Finished Block Quality

Evaluate the blocks against the relevant local standards and intended application. Depending on the product specification, testing may include dry density, compressive strength, dimensional tolerances, drying shrinkage, and water absorption.

NAAC blocks do not automatically achieve the same performance as autoclaved AAC blocks. Their properties depend on the formulation, pore structure, curing regime, and manufacturing controls. Confirm the required performance through appropriate testing rather than assuming that similar appearance means equivalent properties.


Common Configuration Mistakes to Avoid


MistakePotential consequenceBetter approach
Selecting a mixer only by motor powerInadequate batch volume or slow production cyclesConfirm effective capacity and complete batch time
Buying too few moldsPouring stops while existing molds are occupiedCalculate mold demand from occupancy and turnover
Using an unverified foam dilution ratioUnstable foam and inconsistent block densityFollow chemical supplier guidance and conduct trials
Underestimating curing spaceFinished products and green bodies obstruct productionPlan for curing inventory and dispatch frequency
Assuming a fixed power requirementElectrical system may be undersizedVerify the complete equipment list and starting loads
Treating quoted capacity as saleable outputActual deliveries fall below targetDefine capacity basis and measure accepted finished volume
Skipping product testingBlocks may not meet local application requirementsEstablish a quality-control plan before commercial production



Frequently Asked Questions


Does a 30 m³/day NAAC production line need an autoclave?

No. A non-autoclaved line does not use high-pressure steam autoclave curing. It still needs an appropriate curing process and sufficient time for the blocks to develop the required properties.


Can a small factory use manual handling?

Yes, depending on the production layout, mold weight, block dimensions, labor availability, and safety requirements. Manual handling may reduce initial automation costs, but excessive handling can create bottlenecks and increase the risk of damaging green blocks.


How many workers are needed for a 30 m³/day line?

The number depends on automation, material feeding, mold handling, cutting, curing, packaging, and shift length. Ask the supplier for a staffing estimate that identifies each task and clarifies whether the estimate includes material handling and finished-product movement.


Can the line produce different block sizes?

Potentially, yes. Mold dimensions and cutting arrangements can often be adapted to different product specifications. Confirm the available size range, changeover requirements, and achievable tolerances before ordering.


What information is needed for a Hengde quotation?

Prepare your target daily output, raw materials, required block dimensions, target density and strength, available factory area, local power supply, preferred automation level, and project location. These details help Hengde propose a configuration that fits the actual production plan.


Configure Your 30 m³/Day NAAC Line with Hengde

A reliable 30 m³/day NAAC production line requires balanced equipment selection, sufficient mold turnover, controlled foam preparation, accurate cutting, and a curing area sized for the planned output. Evaluating the complete production cycle and verifying saleable capacity can help prevent avoidable bottlenecks after installation.


Contact Hengde at hengdegz@gmail.com to discuss your NAAC block production project. Share your required daily output, block size, raw materials, factory layout, and local product standards to receive a configuration tailored to your manufacturing needs.


Latest News

AAC vs. NAAC Blocks: What Is the Main Difference?

Oct. 26, 2026

AAC vs. NAAC Blocks: What Is the Main Difference?

The main difference between autoclaved aerated concrete (AAC) and non-autoclaved aerated concrete (NAAC) blocks is the curing process. AAC blocks undergo high-pressure steam curing in an autoclave, while NAAC blocks develop strength without high-pressure autoclaving, using a suitable ambient, moist, or other non-autoclave curing method.

How Do You Configure a 30 m³/Day NAAC Block Line?

Oct. 26, 2026

How Do You Configure a 30 m³/Day NAAC Block Line?

A 30 m³/day non-autoclaved aerated concrete (NAAC) block production line should be configured around accurate material batching, controlled foam generation, efficient mixing, suitable molds, reliable cutting, and sufficient curing space.

Low Cost Mini NAAC Plant: A Practical Alternative to Small AAC Plants

Oct. 10, 2026

Low Cost Mini NAAC Plant: A Practical Alternative to Small AAC Plants

A low-cost mini NAAC plant can be a practical alternative to a small AAC plant if your target market accepts non-autoclaved aerated concrete blocks and your production requirements do not specifically demand autoclaved aerated concrete (AAC).

AAC vs NAAC Block Production Line: What Is the Difference?

Oct. 10, 2026

AAC vs NAAC Block Production Line: What Is the Difference?

Choosing between an AAC and a NAAC block production line depends primarily on the building materials your customers require, the applicable product standards, your available investment, and your expected production volume.

NAAC Block Manufacturing Process: From Mixing to Cutting and Curing

Sep. 28, 2026

NAAC Block Manufacturing Process: From Mixing to Cutting and Curing

A NAAC block manufacturing process normally includes raw material batching, mixing, foaming, pouring, pre-curing, cutting, demolding, and non-autoclaved curing.

HOW CAN WE HELP YOU?

We can provide free design and research of different solutions based on your detailed needs. If you need any assistance before making a final decision, please feel free to contact us at any time. We are happy to add value to you!

Contact Us

Contact Us

+86 139 2413 9149

+86 139 2413 9149

+86 13924139149

hengdegz@gmail.com

No. 25 Fulian Road, Fu'an Industrial Zone, Foshan City

(LUCA Authorized Cooperation Base in Germany)

Copyright @ Guangzhou Hengde Building Materials Co., Ltd. All Rights Reserved | Sitemap
